Aerial view of Malibu coastline showing custom homes and ongoing rebuilding projects by ARCA Builders after the Pacific Palisades fires subject to coastal commissions regulations.

The Reality of Rebuilding on Malibu’s Coast

Read Article

Following the destructive Pacific Palisades Fire earlier this year, beachfront homeowners in Malibu are facing an extensive, costly, and technically demanding rebuild process.

As a selected member of the Builders Alliance, ARCA Builders attended the City of Malibu's community summit regarding post-fire regulations and evolving expectations for coastal construction.

Debris Removal Coordination Still Lagging in Malibu

As of the most recent public meeting, only an estimated 30% of Malibu beachfront parcels had submitted Right-of-Entry (ROE) forms to the U.S. Army Corps of Engineers for debris removal. By contrast, ROE submittals across the broader Palisades Fire footprint is closer to 50%.

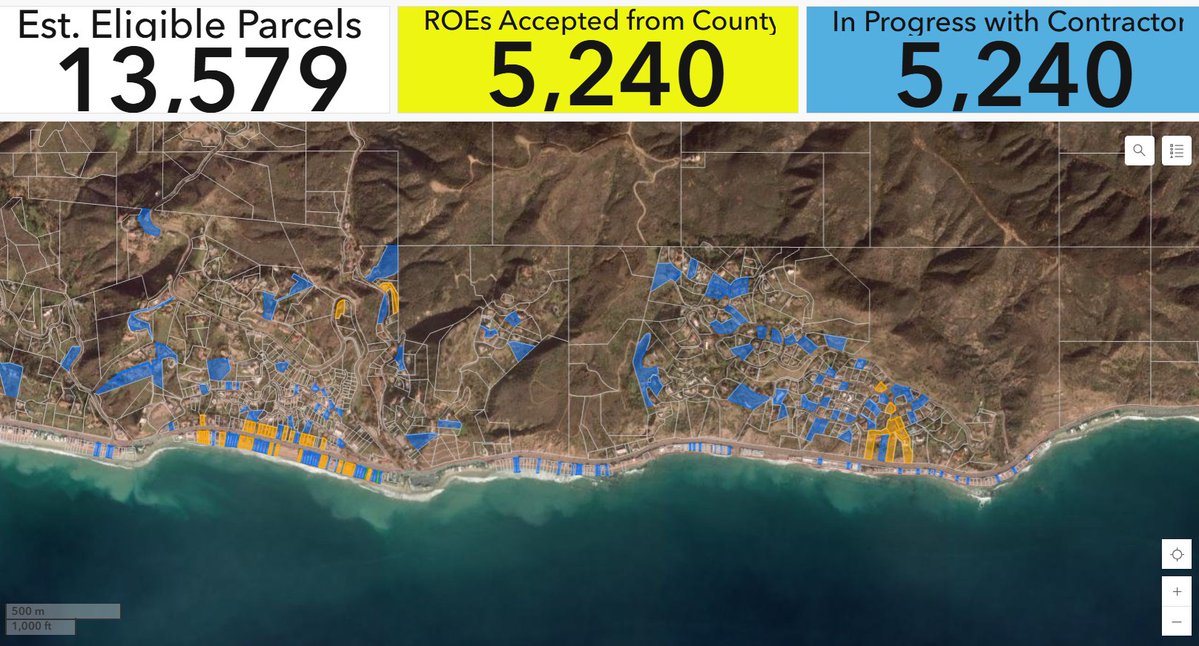

Debris Removal Right of Entry (ROE) forms submitted in Malibu to the Army Corps of Engineers (ACOE).

The gap is due, in part, to the scope and sequence of technical documentation now required prior to site design and entitlement. Without ROE submission, debris removal - and therefore design, geotechnical work, and construction - remains stalled.

Elevation Requirements and Site Constraints

All new structures must sit above FEMA’s Base Flood Elevation (BFE) - roughly 19 feet above sea level and three feet higher than Pacific Coast Highway - so most will need pile-supported foundations. Homes can’t expand toward the ocean or side property lines, only towards PCH.

Elevation Increases and Site Construction Requirements for rebuilding in Malibu after the Pacific Palisades Fires.

Further complicating matters are view preservation restrictions on vertical and horizontal massing. These rules sharply constrain architectural flexibility, particularly for narrow parcels along La Costa Beach.

Square footage, bulk, and height restrictions on Malibu coastla properties after the Pacific Palisades Fires.
Septic No Longer Sufficient, Advanced Wastewater Required

Most existing septic systems do not meet current code and must be replaced. New construction requires installation of Advanced Onsite Wastewater Treatment Systems (AOWTS), a complex and capital-intensive solution.

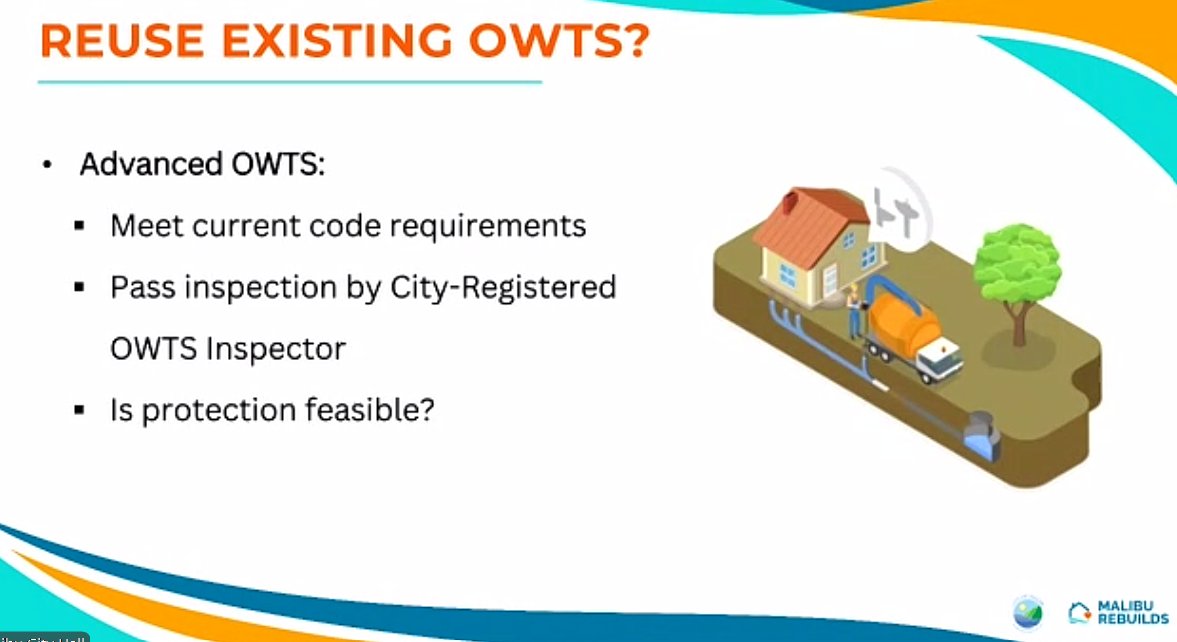

Advanced Onsite Wastewater Treatment Systems (AOWTS) required by Malibu after the Pacific Palisades Fires.

Estimates for a compliant AOWTS range between $300,000 and $350,000 per home. For many, these systems will consume 800-1,000 square feet of area, and their design must be completed before any architectural planning begins.

Existing tanks can only be reused if modified and integrated into a compliant AOWTS design. Temporary protections (e.g., steel plates) may be needed to preserve salvageable systems from demolition equipment during debris removal.

Coastal Engineering and Seawall Mandates

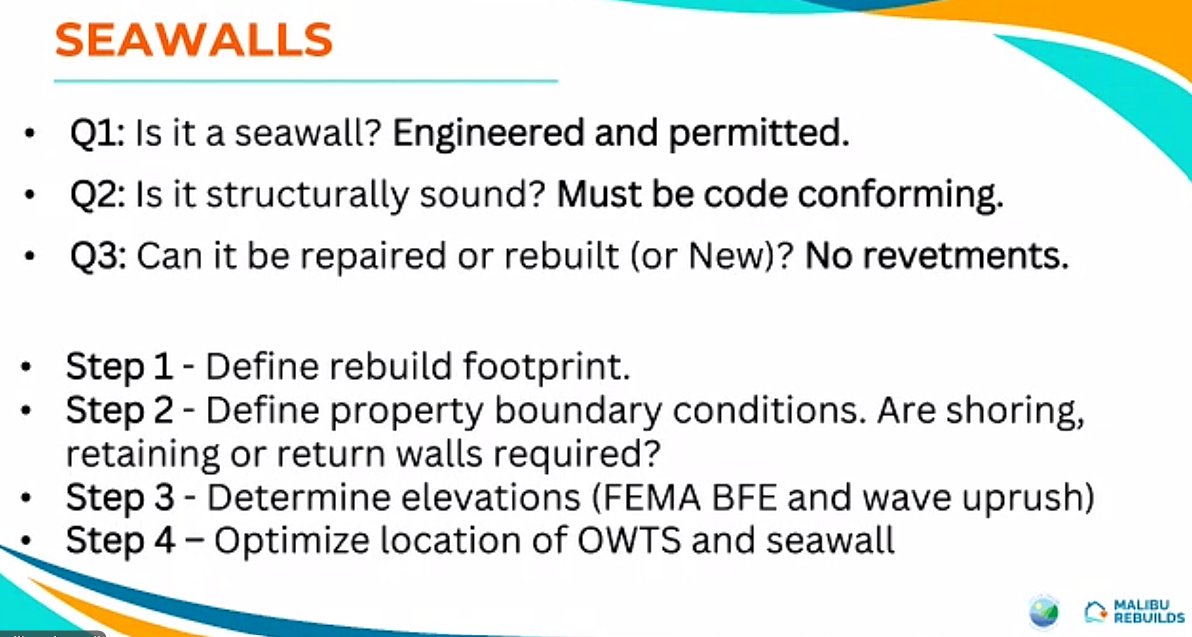

Malibu now requires Coastal Engineering Reports for every beachfront rebuild to evaluate wave uprush and seawall performance. Existing seawalls must be replaced unless a licensed engineer can certify compliance.

The City of Malibu Coastal Engineering and Seawall Mandates for rebuilding after the Pacific Palisades Fires.

Timber piles are not allowed; new seawalls and foundations must rely on concrete systems. The only way to save an existing seawall is if a Coastal or Structural Engineer can validate it is still usable.

The below images show examples of seawalls that will need to be removed and replaced in Malibu if one wants to live on these parcels.

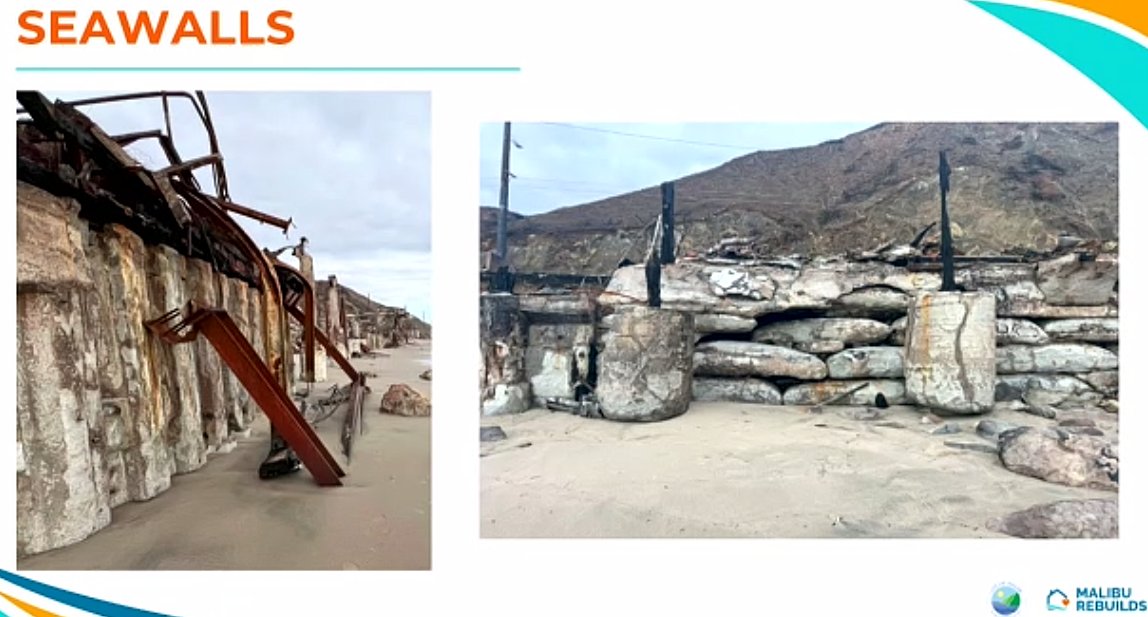

Seawalls requiring demolition and replacement in Malibu during rebuilding after the Pacific Palisades fires.Seawalls requiring demolition and replacement in Malibu during rebuilding after the Pacific Palisades fires.

The city has encouraged shared seawalls between neighbors to reduce redundancy and protect continuous coastal bluffs. However, property line disputes make this approach difficult in practice.

Process Friction and Sequencing Issues

Some of the most expensive engineering work, like soil studies, flood analysis, and wastewater system design, isn’t required when homeowners first submit plans.

But those reports are mandatory later in the process, at the Building Department review. This has led to confusion and delays, especially for those unfamiliar with Malibu’s permitting sequence.

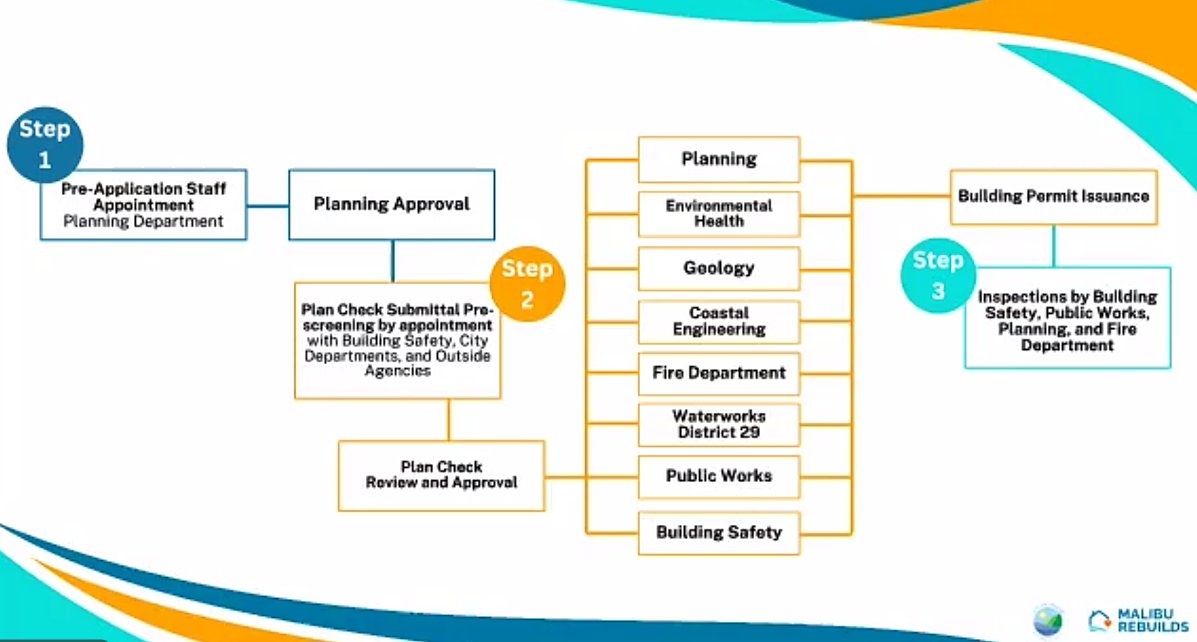

City of Malibu permit guidelines, process, and timeline for rebuilding after the Pacific Palisades fires.
Access and Site Logistics

Contractors are restricted from staging cranes on beaches or neighboring lots. Temporary shoring drawings and crane placement logistics are recommended for early design coordination, but Malibu has not specified a formal review process for these documents.

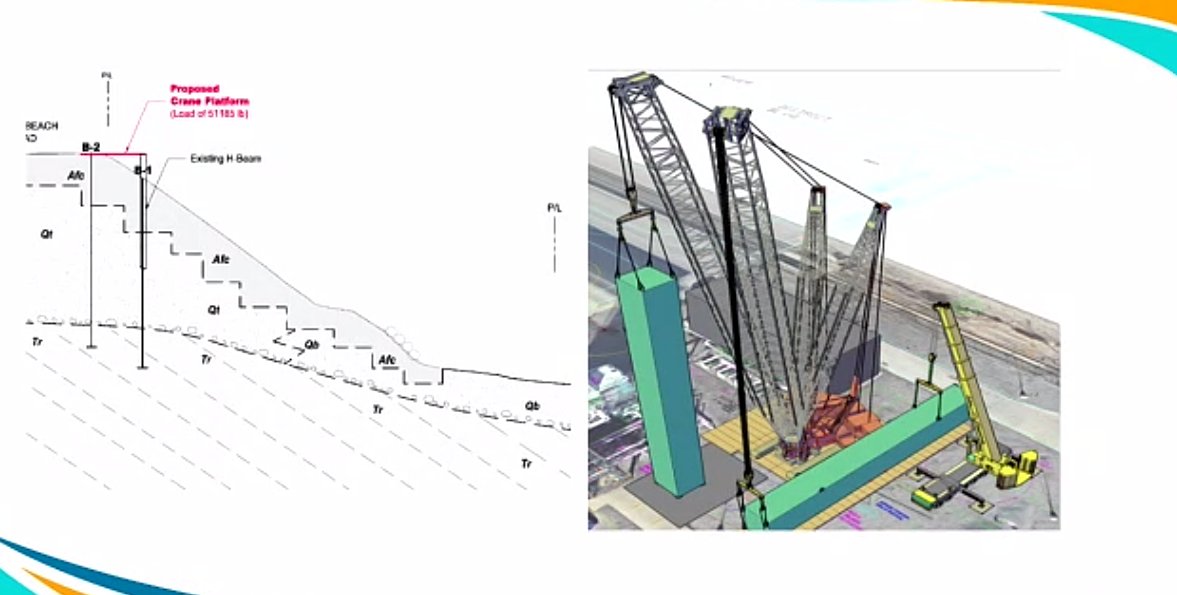

City of Malibu crane location plans for rebuilding after the Pacific Palisades fires.
Policy Gaps and Community Feedback

Residents and professionals voiced concern about the number of costly reports now required for each rebuild. One suggestion was for the City to create shared engineering data for areas with similar conditions, eliminating the need for each property owner to commission separate $20,000+ studies.

A recurring concern was wastewater. Under the new policies, nearly every beachfront property must now install its own advanced treatment system, adding hundreds of thousands of dollars in rebuilding costs.

Some called for Malibu to revisit the idea of a citywide sewer - an option previously rejected when the city was founded in 1991. That decision is now complicating the rebuilding process.

What It Means for Builders and Homeowners

ARCA Builders continues to monitor developments in Malibu and other fire-affected regions. For clients with coastal property, this evolving landscape reinforces the importance of early coordination with geotechnical, coastal, and wastewater engineers prior to initiating architectural design.

We remain available to support feasibility assessments, pre-construction planning, and consultant coordination for rebuilds across high-regulation jurisdictions such as Malibu.
